Guide · Land protection

Can you build on Natura 2000 land or in a Spanish natural park?

14 min · Updated

In this article

Natura 2000 status does not automatically prevent building, but it gives you no right to build. Your proposal must fit the planning rules and the site's protection regime, with assessment of its effects where required. Before committing a deposit, obtain written answers covering the house, access and services, and establish which permissions remain outstanding.

LICSite of Community Importance
ZECSpecial Area of Conservation
ZEPASpecial Protection Area for birds

Ask for these before paying

  • Parcel and project plan against the official boundaries and management zones
  • Designation instrument and current protection and management plans
  • Written town hall information on the intended use and works
  • Nature authority's findings and any required environmental decisions
  • Existing house permissions and evidence of pre-emption notifications where applicable
See my plot's risks

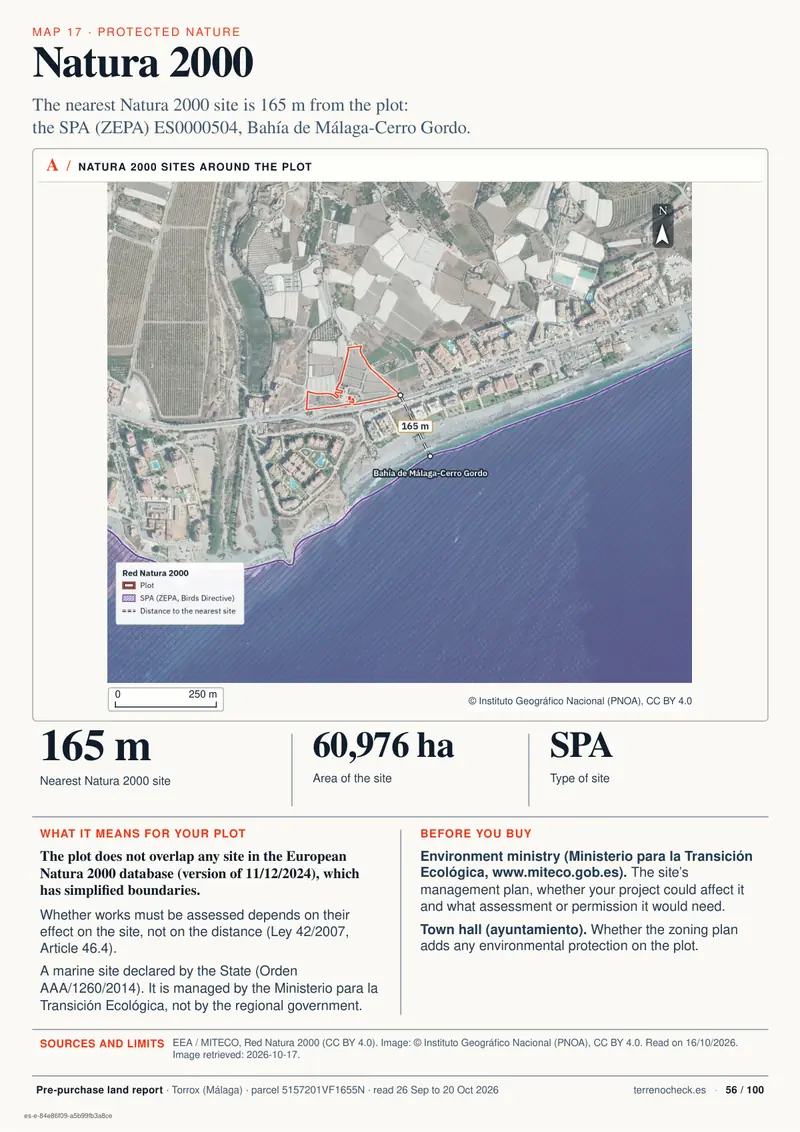

The report shows the plot's Catastro data and mapped risks; it does not say whether you can build.

Sources checked 19 October 2026

Check the site's designation, its management zone and your actual proposal. A house outside the protected boundary can still affect the site and need environmental assessment.

How do you check a Spanish property for nature protection?

Use the MITECO viewer directory to reach the Banco de Datos de la Naturaleza, the ministry's nature database viewer. MITECO is the Spanish environment ministry. Check Natura 2000 and Espacios Naturales Protegidos, the nationally or regionally designated natural protected areas. Looking for a park alone can miss a separate Natura designation.

If you have only the estate agent's location pin, ask for the parcel boundary and a marked position for the house.

  1. Locate the parcel, house and proposed works. Include the access route and service connections beyond your boundary.
  2. Compare Natura and natural protected-area mapping. Keep the names and site codes of every designation, a map and the consultation date.
  3. Follow the regional sources below to the designation instrument and current management documents. Find the zoning map and the rules for the location concerned.
  4. Ask a technician to compare the project with those boundaries. Where maps disagree or a line runs close to the works, seek confirmation from the managing authority.
  5. Request parcel-specific planning information from the ayuntamiento, the town hall. Environmental mapping alone does not establish permitted floor area or residential use.

If the viewer fails, MITECO separately publishes Natura 2000 mapping and natural protected-area mapping, including GeoJSON and KMZ downloads. A technician can compare these with your plan. The ministry recommends consulting regional sources directly because much of its information comes from them. Record which data you used; a coloured screenshot is evidence of a map consultation, not permission for a project.

What do LIC, ZEC and ZEPA actually mean?

LIC stands for Lugar de Importancia Comunitaria, a Site of Community Importance. These sites become ZEC, Zona Especial de Conservación, or Special Areas of Conservation. ZEPA means Zona de Especial Protección para las Aves, a Special Protection Area for birds. The Spanish acronyms are the ones you will encounter in property documents and regional portals.

All belong to Natura 2000. A LIC on the European Commission's approved list is already subject to the assessment regime in article 46.4 of Ley 42/2007: protection does not wait for its conversion to a ZEC (article 46.8).

A parque natural, or natural park, is a different designation. It may overlap a ZEC or ZEPA. You need the applicable rules for each designation, even where they are combined into a coordinated management document. National parks also have their own specific legislation.

Ask for the site's code and the habitats or species it protects. Your adviser needs its conservation objectives to examine the effects of your proposal.

Which document decides what you can do?

The town plan is part of the answer. Nature protection instruments can impose further limits and take precedence over conflicting planning provisions.

A PORN, Plan de Ordenación de los Recursos Naturales, is a natural-resource planning instrument. Its own boundary defines where it applies, and it sets restrictions on activities and uses. Do not assume its scope ends at the park boundary. Under Ley 42/2007, article 19.2, a conflicting town plan must be adapted; meanwhile the PORN prevails.

A PRUG, Plan Rector de Uso y Gestión, is the park's use and management plan. Its rules also prevail over incompatible town planning (article 31.6). Natura management instruments establish conservation objectives and measures and may be integrated into other plans.

Identify the zone covering the works and read its use provisions. Permission for farming does not settle whether a house or tourist business is allowed. Request missing documents from the nature authority managing the site.

Ask about pending procedures too. Article 23 restricts transformations while a PORN is being prepared and requires a favourable authority report for the transformations it covers once the approval procedure begins. Proposed LIC sites have preventive protection once their list reaches the ministry for forwarding to the Commission, before approval as LIC (article 43.2). Request the published measures and boundaries: a map of declared sites may miss these restrictions.

For the separate question of planning classification and rural housing, read the guide to rustic, urban and developable land.

Protected land: the checks for your projectPlanning and protection rulesDo they allow the use and works?If prohibited, stop.If allowed, continue.Could it appreciably affecta Natura 2000 site?Effects from outside the site count too.Yes / not ruled outNo, substantiatedAppropriateassessmentof site effectsContinue only withno adverse effecton site integrity.Substantiate noappreciable effectsExpress managementplan provision ornature authority reportContinue only if your route is satisfied.Check other assessments and consents.Adverse effect: no ordinary approval.Public-interest exceptions have their ownstrict requirements.
The checks accumulate. A study does not make a prohibited use permissible. The route without Natura assessment requires substantiated absence of appreciable effects; missing data is insufficient. Effects from outside the site count too.

Can you build a house, extend or change its use?

Ley 42/2007 does not provide one building allowance or national minimum house plot for every ZEC. The proposed use and works must satisfy the applicable planning and protection rules. On legally protected rural land, alterations must be expressly allowed by the relevant protection legislation (the state Land Act, article 13.1).

Give the authorities a proposal they can assess. Avoid a question as broad as whether it is possible to renovate a finca, a word which may refer to the land, the house or the registered property.

  • New house or extension: mark the footprint and proposed floor area and describe earthworks. Establish whether the use and works are admissible before commissioning detailed design.
  • Repair or reconstruction: identify what stays, what is demolished and the intended use. An existing repair permission does not establish consent for a different project.
  • Pool, fence or access track: show the route or location and associated works. Ask about the management rules and possible habitat or wildlife effects.
  • Services: include the power and water routes, drainage and wastewater disposal. Acceptance of a house does not automatically settle these elements.
  • Agriculture or visitor accommodation: explain the existing authorised use and intended change, including any installations. A change in operation should not be presented as routine maintenance.

Ask the authority to identify the applicable provision and approvals for each element. If the answer is only that something is possible in principle, establish what remains before work can start.

What if you are buying an existing rural house?

If you intend to keep the house as it stands, focus on its permissions and authorised use. Obtain the relevant files and compare the approved scheme, environmental conditions and actual building. Have your lawyer ask about enforcement or restoration proceedings as part of the purchase checks.

Establish whether environmental assessment was required and completed before construction. If required assessment was omitted, do not buy on the assumption that a late study will put matters right. Article 9.1 of Ley 21/2013 excludes the impact-assessment procedure under Title II of that Act for projects covered by article 7 that have already been wholly or partly executed without prior assessment. Have your lawyer establish the consequences and the applicable legal route before committing to the purchase.

For unfinished projects, check that environmental decisions remain effective. A declaración de impacto ambiental, DIA, the decision following ordinary assessment, normally lapses if execution has not begun within four years of publication. A favourable informe de impacto ambiental, IIA, the report from simplified assessment, instead requires project authorisation within four years of publication (Ley 21/2013, articles 43.1 and 47.4).

Check extensions and any suspension of the clock. Obtain the decisions and evidence of the relevant milestone. For a DIA, unless specific rules provide otherwise, commencement means physical works or installation after all required authorisations have been obtained, with that fact recorded by the administration. The promotor, the person advancing the project, must notify the environmental authority of the start date. A photograph of earthworks alone is insufficient.

Do not assume an old house carries a right to extend, rebuild or switch to holiday accommodation. Nor does a neighbour's approval settle your project: the applicable zone and effects may differ. The guide to unlicensed rural houses deals with the separate question of the building's legal status.

A roof repair can also raise a species issue if there may be bat roosts or nests. Before clearing vegetation or disturbing a roof, ask whether protected species are involved. Ley 42/2007, article 57.1, protects breeding and resting places of animals on the special-protection list. Those protections are not confined to Natura polygons. Have a specialist establish the facts and any required measures rather than assuming ordinary maintenance is unrestricted.

When is environmental assessment required?

Spanish paperwork uses several similar expressions. Evaluación ambiental estratégica is strategic assessment of a qualifying plan or programme. Evaluación de impacto ambiental is impact assessment of a project. Evaluación de repercusiones sobre Red Natura 2000 examines effects against the site's conservation objectives within the applicable procedures.

The rule in Ley 42/2007, article 46.4, concerns plans, programmes and projects unconnected with, or unnecessary for, site management that could appreciably affect the site's species or habitats. Effects must be considered both individually and together with other proposals. A location inside Natura does not automatically require ordinary impact assessment; a location outside does not automatically avoid assessment.

Under Ley 21/2013:

  • Ordinary impact assessment applies to annex I projects and the other cases in article 7.1.
  • Simplified impact assessment covers annex II projects and other statutory cases. Article 7.2.b includes projects outside both annexes that may appreciably affect Natura sites, directly or indirectly.

Calling the works small does not answer that test. Simplified assessment can require ordinary assessment, find no significant adverse effects subject to stated terms, or end without a substantive conclusion because there is insufficient information. It does not grant a shortened building licence.

The seventh additional provision allows a management connection or absence of appreciable adverse effects to be substantiated through an express management-plan provision or a report from the competent nature authority managing the site. In the specified cases it allows assessment to be dispensed with. Ask whether your proposal meets its conditions and whether another assessment trigger applies, including the statutory annexes and regional rules. General acceptance of farming does not establish this for a house.

For simplified assessment, the promotor submits the environmental document to the authority handling the underlying project permission. It must address Natura effects specifically where applicable (article 45.1). Use a specialist familiar with the site. Before commissioning work as a prospective buyer, agree the seller's cooperation, access for surveys and files, and any necessary representation. Settle who pays if the sale fails; intending to buy does not itself make you the promotor in an existing application.

The normal approval test after Natura assessment requires the authority to ascertain that the proposal will not adversely affect site integrity. The exceptional route for overriding public-interest reasons has strict conditions. Do not commit purchase money on the assumption that you can pay for compensation and obtain permission for an otherwise harmful scheme.

Required assessment comes before project authorisation or, where applicable, a declaración responsable, a formal declaration of compliance. Missing environmental decisions cannot be treated as favourable assessment through administrative silence (Ley 21/2013, articles 9 and 10).

Where should you check in each region?

Find the site's documents through these regional sources:

Who answers, and how do you budget for the checks?

Send the town hall and regional nature authority an identified parcel, plan and description of the proposed use and works. Ask which designations and plans apply, the relevant zone, whether the proposal is compatible, and what reports, authorisations and assessment it needs. Request the legal basis and the office responsible for each matter.

The authority managing the site may differ from the environmental assessment authority. The órgano sustantivo handles the underlying project authorisation; regional law allocates roles for local projects. Your adviser should establish the route rather than assume a town hall reply resolves every environmental requirement.

Seek written professional quotations and ask the administration about charges for the actual procedure. Have the technician explain any surveys and timing constraints before agreeing a deposit deadline.

Murcia's procedure 482 for protected-area authorisations and reports lists no initiation fee, a 3-month decision period and negative administrative silence: an unanswered application is treated as refused. That is not the timetable for every environmental assessment or municipal licence.

What must be settled before a deposit?

Check administrative acquisition rights too. Ley 42/2007, article 40, provides regional tanteo and retracto powers for specified transactions inside natural protected areas. These let the administration acquire on the notified terms, before the sale through tanteo or after transfer through retracto. The seller must formally notify price and terms; regional law sets the exercise periods. Have your lawyer check delivery, matching transaction terms and waiver or expiry of the applicable period. Proof of notification needed for registration does not itself establish that the right has ended. Check the site's regime; do not assume every Natura-only designation creates these rights.

Before committing purchase money

  • Official boundaries, management zone and complete project locationTechnician and nature authority · professional quote · establish feasibility before committing
  • Permitted use and works under planning and protection rulesTown hall and nature authority · ask about procedure charges · written findings before an unconditional deposit
  • Assessment route, decisions and environmental conditionsSpecialist and competent authority · quote for studies · confirm the actual procedure timetable
  • Existing building's use, permissions and filesLawyer and technician · agreed fees · review before commitment
  • Pre-emption notifications and deposit refund conditionLawyer and seller · agreed fees · resolve regional periods before setting completion

Arras are the purchase deposit arrangements; a reserva is a reservation payment. Where permissions remain unresolved, ask your lawyer to negotiate a condition tied to the precise project and an attached plan. Define the written findings or actual consents needed, the deadline and repayment of all sums if refused or not obtained. Specify who refunds each payment, including money retained by an agency. This is a contractual safeguard to agree, not an automatic refund right arising from Natura status. Read the guide to Spanish deposit contracts before accepting the seller's wording.

Do not pay an unprotected deposit yet if:

  • Nobody has identified the current plan or the zone covering the works.
  • The only assurance is an advertisement, screenshot or verbal answer.
  • You are asked to buy first and resolve a pending assessment later.
  • The purchase depends on access or wastewater arrangements still unchecked.
  • Building permissions, required notifications or agreed refund arrangements are missing.
Already have a plot in mind?

Find it on the map, confirm the boundary and get the report as two PDFs (100 pages in English and 99 in Spanish in the sample report; the length of each order depends on the plot), with its sources and dates.

Check a plot

Frequently asked questions

Can you buy property within Natura 2000?

The designation does not itself prevent a sale. Establish whether the intended use is viable and whether acquisition rights affect the transaction. The ability to purchase the land does not demonstrate a right to develop it.

Can land outside a natural park need assessment?

Yes, where the proposal may appreciably affect a Natura site, including indirectly. Check any peripheral protection zone and the PORN's own scope as well. The park boundary does not settle every restriction or effect.

Does every renovation in a ZEC need ordinary impact assessment?

Location alone does not decide it. The project, effects, statutory assessment triggers and applicable rules determine the route. Ask for a reasoned answer for the actual works; other permissions may still be required even without ordinary assessment.

Does a favourable environmental report replace the building licence?

No. Meet its conditions and obtain the required project approvals. Preliminary compatibility advice is not a building licence either, and should not be treated as covering different works from those described in the enquiry.

Can existing farming continue without checking the rules?

Review management measures and conditions attached to existing permissions. Ask about intended changes, such as new infrastructure or alteration of the land, even if farming predates designation.

Sources

SourceWhat it backsChecked
BOE, Ley 42/2007, Natural Heritage and Biodiversity Actarticles 19.2, 20, 23, 29–31, 37–38, 40, 42–46 and 57.1; protection instruments, interim safeguards, acquisition rights and Natura assessment19 Oct 2026
BOE, Ley 21/2013, Environmental Assessment Actarticles 6, 7.1, 7.2.b, 9, 10, 11, 43.1, 45.1, 47.2 and 47.4 and seventh additional provision; assessment triggers, validity periods and Natura procedure19 Oct 2026
BOE, state Land Act, Real Decreto Legislativo 7/2015articles 5.c–d, 11.3 and 13.1; written planning information, project consent and protected rural land19 Oct 2026
MITECO, cartographic viewersofficial directory and current BDN viewer link19 Oct 2026
MITECO, Natura 2000 cartographydownloadable boundary datasets, including GeoJSON and KMZ19 Oct 2026
MITECO, natural protected areasseparate protected-area boundary downloads19 Oct 2026
MITECO, Banco de Datos de la Naturalezaregional provenance of much of the data and advice to consult regional sources19 Oct 2026
Junta de Andalucía, natural-area planningREDIAM access to PORN, PRUG and zoning documents19 Oct 2026
Generalitat Valenciana, cartographic viewerregional mapping and protected-area lookup19 Oct 2026
SITMurcia, Patrimonio Naturalregional protected-area mapping and Natura planning links19 Oct 2026
CARM, procedure 482protected-area reports and authorisations; no initiation fee, 3-month decision period and negative silence, Murcia only19 Oct 2026
Generalitat de Catalunya, thematic applicationsofficial link to the protected natural areas viewer19 Oct 2026
Generalitat de Catalunya, protected-area viewer manualcoverage of Natura, PEIN and special-protection designations19 Oct 2026
Govern de les Illes Balears, Natura cartographyofficial IDEIB access19 Oct 2026
Gobierno de Canarias, planning-system directorymapping, planning archive and protected-area instruments19 Oct 2026

This guide is general information on the rules in force on the date checked. It is not legal advice: for a specific purchase, ask a lawyer or the notary.

Written and reviewed by the TerrenoCheck team (Kandyb Studio - Paweł Kandybowicz, responsible for the content). Each statement is checked against the official source linked in the table, on the date shown. If you find a mistake, write to us and we will correct it.
