Guide · Natural risks

How does seismic risk affect buying or renovating a house in Spain?

14 min · Updated

In this article

A property in a seismic area can be a viable purchase, but establish its structural condition and the cost of your intended works before committing money. Look up the municipality's basic acceleration under NCSE-02, then commission an independent assessment. The code supplies technical requirements, not a percentage surcharge for building or renovation.

0.23 gbasic acceleration for Granada municipality
0.15 gbasic acceleration for Murcia municipality
0.14 gbasic acceleration for Alicante/Alacant municipality

Ask for these before paying

  • Original and amended designs, with seismic justification under the rules applicable to each project
  • Ground investigation and completed-work records, if available
  • An independent assessment covering the house and your proposed alterations
  • Damage and repair records, outstanding safety orders, insurance policy and premium receipt

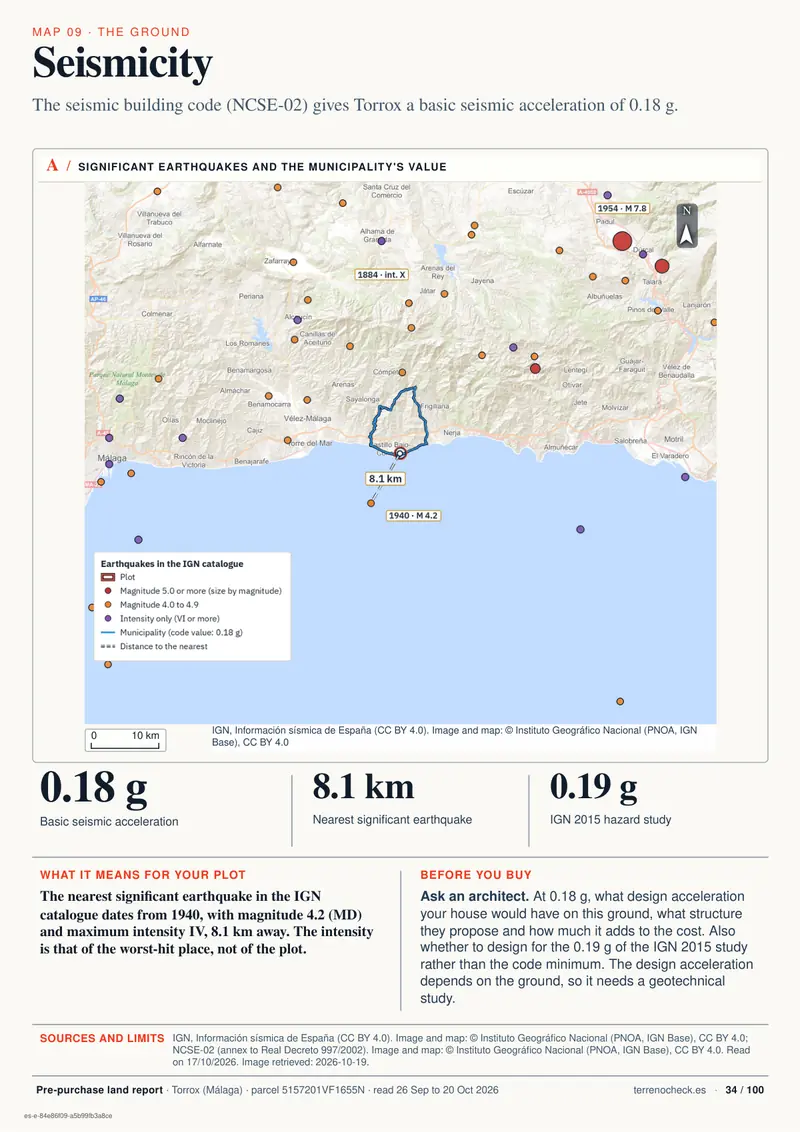

See my plot's risks

The report shows the plot's Catastro data and mapped risks; it does not say whether you can build.

Sources checked 19 October 2026

Check the municipality's NCSE-02 acceleration, then have the house and proposed works assessed. A map value cannot tell you whether a house is safe or what strengthening will cost.

How do you find the seismic map value for a Spanish property?

Identify the actual municipality before comparing locations. An estate agent's description such as “Granada countryside” or “Málaga coast” can cover properties in different municipal areas. Give your architect the cadastral reference, the building's location and your intentions for it. Keeping the house as it stands is a different brief from removing walls or replacing the roof.

NCSE-02 is Spain's current state seismic construction standard for buildings, approved by Real Decreto 997/2002, a royal decree. Open it through the IGN standards index.

  1. Open the official PDF and find figure 2.1, Mapa de Peligrosidad Sísmica, the national seismic hazard map. Use it to understand the property's wider setting.
  2. Find the municipality in anejo 1, the municipal annex, arranged by autonomous community and province. Record ab, basic acceleration, and K, the contribution coefficient. The annex lists municipalities with ab of at least 0.04 g.
  3. Ask the designer to identify the source used and explain how the project derives its seismic design action. Keep the relevant page with the property documents.

The map describes ground-shaking hazard. It does not inspect the building, identify a future earthquake date or grant planning permission. Establish what the local plan allows you to build as a separate enquiry. A technically feasible structure still needs a permissible project.

From municipal data to the purchase decisionAfter locating the property, choose the relevant path: assess an existing home without planned works, or establish the rules and design for building works. NCSE calculation uses ac equals S times rho times ab where applicable. Define and cost any necessary measures before the deposit.MUNICIPALITY AND YOUR PLANSab and K: NCSE-02 map and annexIdentify the property and intended worksEXISTING HOMENO PLANNED WORKSNEW BUILDOR RENOVATIONAssess conditionand seismicvulnerability.Identify any furtherchecks or measures.Buying alone does notrequire strengtheningRules and designIf NCSE applies:ac = S × ρ × abS: amplificationρ: importanceK: response spectrumCOST THE SCOPE BEFORE A DEPOSITDefine and price any necessary measuresab does not set a priceTwo paths; no automatic duty to carry out works
Buying without planned works and designing works follow different paths. Assessment defines any measures needed; the formula belongs to NCSE design where applicable. NCSE-02, sections 1.2 and 2.1–2.4; DB-SE, Annex D.

Buying without planned works? Go to the existing-house assessment and the checks before a deposit.

What does a basic acceleration of 0.14 g actually mean?

Basic seismic acceleration characterises horizontal acceleration at the ground surface relative to gravity, g. It gives neither earthquake magnitude nor the probability of losing the house.

The code derives design acceleration through ac = S × ρ × ab. S represents ground amplification. The risk coefficient ρ (rho) depends on the building's importance: 1.0 for normal importance and 1.3 for special importance. K helps define the response spectrum, which describes how seismic response varies with vibration period. It is not another multiplier in this formula.

Ground conditions influence S; structural design also needs information about the building. NCSE categories range from compact rock to loose granular or soft cohesive ground. A garden's appearance or the seller's assurance about “solid ground” cannot establish that classification.

There is also a distinction between ground amplification and ground instability. The ground coefficient does not itself resolve slope movement, potential collapse or liquefaction. Ask whether the available investigation addresses the relevant issues at this site and what further work would be needed. Comparing ab alone will not answer those questions.

Which values apply in Granada, Murcia, Alicante, Almería and Málaga?

These are municipal entries in the NCSE-02 annex. They are not province-wide values and do not rank the condition of houses for sale. The autonomous-community names help you locate the entries in the official document.

MunicipalityAutonomous communityBasic acceleration ab
GranadaAndalucía0.23 g
Santa FeAndalucía0.24 g
MurciaRegión de Murcia0.15 g
LorcaRegión de Murcia0.12 g
Alicante/AlacantComunitat Valenciana0.14 g
OrihuelaComunitat Valenciana0.16 g
AlmeríaAndalucía0.14 g
Roquetas de MarAndalucía0.13 g
MálagaAndalucía0.11 g
Vélez-MálagaAndalucía0.18 g

Find your property's municipality. Do not use the provincial capital's figure or interpolate between entries in this table yourself.

These are state rules, with a national map including the islands. If you cannot find a municipal entry, ask your professional to confirm the map value and application criteria; absence is not a safety certificate.

Why might the newer IGN map show another figure?

The IGN also publishes a 2016 hazard tool for Spain's National Annex to UNE-EN 1998, associated with Eurocode 8. You can select a point or enter coordinates. It returns interpolated PGA, peak ground acceleration, and K for a 475-year return period.

That is a separately identified map, not the municipal annex of NCSE-02. Do not copy its PGA into an NCSE calculation's ab field without a justified design approach. Ask which framework the designer is using and how the seismic action, ground parameters and design rules fit together.

NCSE allows the designer or works director to adopt different criteria under their responsibility if the resulting safety and service level is no lower than the code requires and the approach is recorded in the project. Publication of the viewer does not supply that justification. When reports disagree, first check that they describe the same parameter from the same source.

Does every house need an NCSE-02 seismic calculation?

The code classifies buildings by use and the consequences of their destruction. An ordinary occupied home usually falls under normal importance; a small rural house is not automatically of moderate importance. However, section 1.2.2 puts buildings officially classified as historic or artistic monuments, of cultural interest or similar into special importance. If the house has heritage protection, have its precise designation checked against that section. Residential use alone does not determine ρ.

Section 1.2.3 excludes moderate-importance construction from mandatory application. It also excludes normal- or special-importance buildings where ab is below 0.04 g. A further exception covers normal-importance construction with frames well braced together in every direction where ab is below 0.08 g. Even then, the code applies to buildings above seven storeys if design acceleration ac is at least 0.08 g.

“Below” matters: a value equal to the threshold does not meet that wording. A concrete frame alone does not establish the bracing exception. At ab of at least 0.04 g, earthquake effects on potentially unstable ground must also be considered. Obtain a written explanation if someone says the project is exempt.

Section 1.3.1 requires an Acciones sísmicas (seismic actions) section in every works project's explanatory memorandum. An exception to calculation needs justification, rather than omission of the section. For an old design, check which rules applied at its date; do not assume every historical file had to cite NCSE-02.

Section 1.2.3 also limits brick, mortar-block or similar masonry buildings to four storeys where ab is at least 0.08 g but below 0.12 g, and two where ab is at least 0.12 g. This concerns the masonry structural system. Brick cladding on a framed building is a different case, and these provisions are not the local planning height limit. An extra storey needs both structural and planning checks.

Must an older house be upgraded just because you buy it?

Buying does not itself require reconstruction to new-build standards. Owners must nevertheless maintain legally required safety conditions under TRLSRU, the state Land and Urban Rehabilitation Act (article 15.1.b). A sale does not remove the owner's planning duties (article 27.1). Ask the town hall and seller for outstanding repair or safety orders and evidence of compliance. Have your lawyer and architect establish the remaining obligations and cost.

CTE, the Código Técnico de la Edificación or national building code, includes DB-SE, its structural safety document. Annex D bases existing-building assessment on actual conditions and warns against directly applying new-build sizing rules.

Agree explicitly whether the assessment covers seismic vulnerability and what further analysis might be needed. A visual survey finding no damage does not verify earthquake performance. DB-SE D.6.1.2 warns that qualitative assessment may be insufficient for extraordinary design situations. The report should identify the structure and relate its condition to your intended works, separating verified findings from concealed details and explaining any need for opening-up, tests or calculation.

Request designs, amendments, completion and repair records. Where applicable, the Libro del Edificio, or building record book, contains completed-work documentation, acceptance records, the parties involved and maintenance instructions (LOE, the Ley de Ordenación de la Edificación or Building Act, article 7). Ask about the municipal archive for missing drawings and arrange access with the seller.

A filled crack is not enough to diagnose earthquake damage from a photograph. Request its history and any assessment of its cause. NCSE section 1.3.3 requires a report after a high-intensity earthquake for constructions in areas experiencing intensity VII EMS or greater. This is local intensity, not the earthquake's magnitude. Responsibility lies with the professional responsible for maintenance; where there is none, the owner or operator must commission a competent professional. If that threshold affected this property, ask the seller for the report on damage and proposed measures, with evidence of the repairs completed.

What changes if you remove walls or undertake a major renovation?

For renovation and rehabilitation, NCSE must be taken into account so that affected elements achieve greater safety than in their original conception. Substantial structural changes, such as gutting the interior and retaining only the façade, are treated as new construction for these purposes.

Replacing finishes presents a different brief from opening a load-bearing wall. Give the architect your proposed layout before seeking a builder's price. The code addresses the distribution of stiffness and the possible influence of partitions and enclosing walls. Removing something described casually as a partition can affect the assessment if its actual role has not been established.

CTE requires compliance to be justified for interventions in existing buildings and the project to identify whether the existing structure is affected (articles 2.3 and 2.4). Technical, economic, planning or heritage constraints require professional justification; they are not a general exemption for an old property. A change of characteristic use has its own requirements under article 2.6. Converting a farm store into a dwelling needs that assessment as well as planning permission for the use.

LOE requires a project for the interventions described in article 2.2, including specified changes to the structural system and characteristic use. Have the architect identify the documentation your works need and confirm the administrative route with the town hall.

How much extra should you budget for seismic construction or renovation?

NCSE sets no construction price or fixed percentage uplift. Price the defined structural solution separately from finishes.

For a new house, ask for separate allowances or quotations covering ground investigation, structural design, foundations and ties, the resisting structure, and any required connections or joints. Include execution checks. Ground and design determine the solution; the map alone cannot specify a specialist foundation.

For an existing house, keep the assessment fee separate from the resulting works. A works quotation should identify access and opening-up, temporary support where required, the structural intervention and reinstatement of finishes. Have exclusions written down. If testing has yet to establish the scope, the estimate should say which costs remain unresolved rather than treating them as included.

A proyecto básico, or basic design, may support a licence application but is insufficient to start construction. The proyecto de ejecución, or detailed execution project, defines the whole works (CTE, article 6.1). Compare contractors against the same scope and design. Ask who will decide and price changes if opening up reveals a structure different from the drawings.

What insurance should you check for earthquake damage?

Meeting NCSE requirements does not mean the house will escape earthquake damage. The Consorcio de Compensación de Seguros, Spain's public extraordinary-risk insurer, covers earthquake damage under its statutory scheme. Ownership alone gives no entitlement: you need an eligible policy under article 4 of RD 300/2004, with the Consorcio surcharge and premiums paid.

Ask the insurer to confirm the insured property and sums, how underinsurance affects payment, and the cover's start date, including any applicable waiting period (articles 5, 6 and 8). Article 6.c excludes damage caused by an inherent defect in the insured property or its manifest lack of maintenance. Resolve identified defects rather than relying on the policy to fund their repair. Check both continente, the building, and contenido, its contents, and establish protection for your ownership and intended use from purchase. Discuss renovation separately: construction and erection policies are excluded from the compulsory-surcharge scheme. Do not assume the Consorcio covers your works under either a construction policy or your home policy.

What should be settled before paying a reservation or arras deposit?

Arras means a contractual purchase deposit. A reserva is a reservation payment or agreement; check what the document commits you to. Arrange the structural enquiries before signing or paying under either agreement.

The report should establish whether works can be defined and priced, identifying outstanding investigations and access limitations.

Who handles each check, and what cost and timing to agree

  • Confirm municipality, ab, K and the proposed worksArchitect · include this task in the agreed fee · delivery date before committing the deposit
  • Assess the house and seismic vulnerability, stating the report's limitsIndependent competent building professional · scoped quotation · timetable agreed once documents and access are available
  • Obtain further ground data, opening-up or tests where neededDesigner and specialists · separate quote and authorised access · programme based on the investigation required
  • Check planning feasibility, heritage status and outstanding safety ordersTown hall, lawyer and architect · enquiry and professional fees quoted · confirm the response timetable before a deposit
  • Define the intervention and price unresolved workDesigner and contractor · itemised quote with exclusions · settle before accepting the purchase-and-works budget
  • Agree reservation or deposit conditionsYour lawyer · agreed fee · wording reviewed before transferring money
  • Confirm insurance for ownership and intended worksInsurer or broker · quoted premium · written cover and start date before purchase

Ask your lawyer to specify access, document delivery, a review deadline and the technical findings or agreed cost limit that would let you withdraw. The agreement should state how money is returned and who is responsible for sums paid to an agent or seller. These are terms to negotiate: have the agreement state the refund entitlement rather than assuming an adverse report is enough. Read the guide to arras and deposit agreements.

Do not pay the deposit yet if:

  • The only seismic figure supplied belongs to the provincial capital rather than the property's municipality.
  • Necessary access is refused, or repairs or safety orders remain unexplained and unpriced.
  • Your layout depends on removing walls whose structural role has not been checked.
  • Someone asserts an NCSE exception without a written technical justification.
  • The renovation quote excludes unresolved structural work and you need that cost to decide whether to buy.
  • The deposit terms do not resolve what happens to your money if the agreed technical review prevents you proceeding.
Already have a plot in mind?

Find it on the map, confirm the boundary and get the report as two PDFs (100 pages in English and 99 in Spanish in the sample report; the length of each order depends on the plot), with its sources and dates.

Check a plot

Frequently asked questions

Does seismic risk prevent building in Granada or Murcia?

The map value alone is not a general prohibition on building. The particular project must meet the applicable technical requirements and land-use restrictions. Establish both before buying a plot for a new house.

Does a building licence prove a house is safe in an earthquake?

A licence does not replace an assessment of its present condition. Request the design, amendments and available completed-work records. The professional needs to compare those with the actual building and subsequent damage or alterations.

Must every house built before NCSE-02 be strengthened?

There is no general upgrading duty arising simply from buying it. Age does not establish safety either. An assessment considers the actual structure and intended use; renovation can require improvements, and substantial structural changes can be treated as new construction for these purposes.

Can I calculate the extra cost from basic acceleration?

No. NCSE assigns no prices to the map values. Establish the ground conditions, structure and intervention before requesting comparable quotations. Keep the assessment fees separate from the works subsequently identified.

Does the IGN 2016 viewer replace the NCSE-02 municipal annex?

Publication of the tool does not itself replace that annex. It identifies a different map and parameters. The designer must justify the framework used and any alternative approach against the required safety and service level.

Sources

SourceWhat it backsChecked
BOE, Real Decreto 997/2002approval, scope and legislative analysis; BOE provides the original text, with no consolidated edition available19 Oct 2026
BOE, complete NCSE-02 annexsections 1.1–1.3, 2.1–2.4 and chapter 4; hazard map and municipal values in Annex 119 Oct 2026
IGN, seismic construction standardsseparate official access to NCSE-02 and Eurocode National Annex mapping19 Oct 2026
IGN, 2016 seismic hazard toolcoordinate enquiry, PGA, K and return period; a different map from the NCSE municipal annex19 Oct 2026
BOE, Código Técnico de la EdificaciónPart I, articles 2.3, 2.4, 2.6 and 6.1; existing-building works, use changes and design documentation19 Oct 2026
BOE, Ley de Ordenación de la Edificaciónarticles 2.2 and 7; works requiring a project and completed-building documentation19 Oct 2026
Código Técnico, DB-SEAnnex D, assessment of existing buildings, investigation stages and condition evidence19 Oct 2026
BOE, Civil Codearticles 1114, 1255 and 1256; agreed conditions and their limits, supporting the contractual technical-review recommendation19 Oct 2026
BOE, Land and Urban Rehabilitation Actarticles 15.1.b and 27.1; safety maintenance and transfer of the owner's duties19 Oct 2026
BOE, Extraordinary Risks Insurance Regulationsarticles 1, 4, 5, 6 and 8; earthquakes, eligible policies, sums, exclusions and start of cover19 Oct 2026

This guide is general information on the rules in force on the date checked. It is not legal advice: for a specific purchase, ask a lawyer or the notary.

Written and reviewed by the TerrenoCheck team (Kandyb Studio - Paweł Kandybowicz, responsible for the content). Each statement is checked against the official source linked in the table, on the date shown. If you find a mistake, write to us and we will correct it.
